/


The development budget for an AI project usually looks reasonable on the day it is approved. Then something happens. A requirement was misunderstood. A specialised skill wasn’t available. An integration doesn’t work as expected. A bug survives until QA.

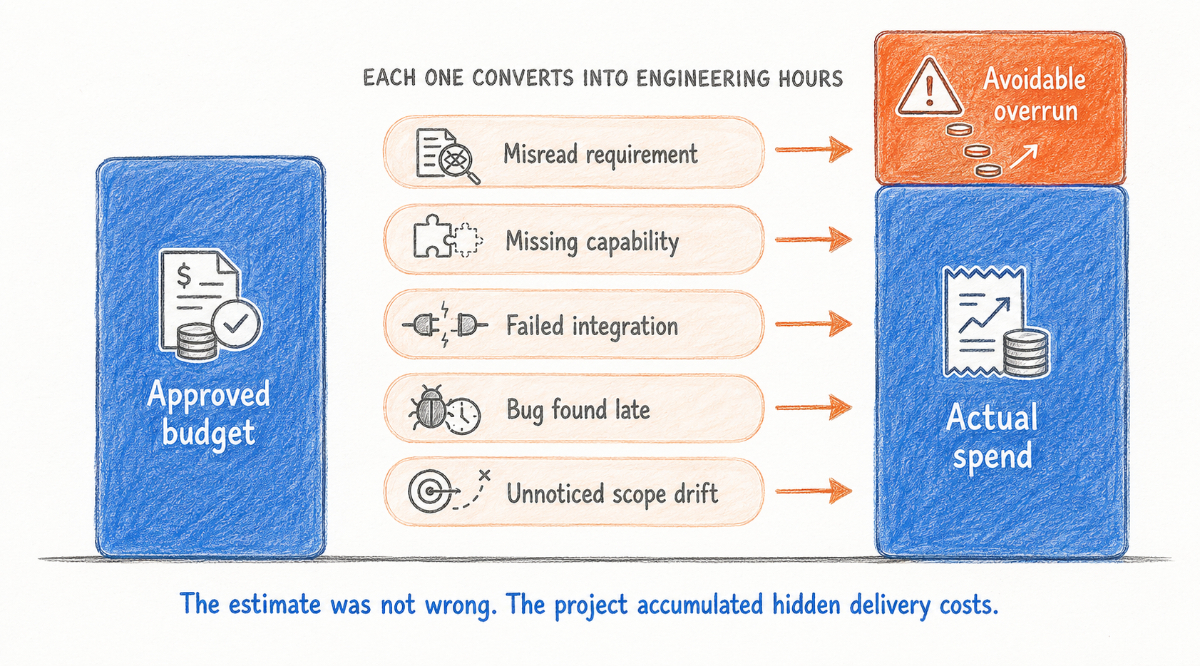

None of this proves the original estimate wrong. But every one of these events converts into the same currency: additional engineering hours. Two extra weeks here, a repeated QA cycle there, and a correctly priced project overruns anyway. Figure 1 shows the pattern.

The numbers say this is the norm, not the exception. In a February 2026 survey of 500 enterprise finance leaders, 79% reported AI cost overruns in the previous twelve months, and only 15% could calculate AI ROI without significant obstacles. Gartner now predicts that at least half of all generative AI projects will overrun their budgets, citing poor architectural choices and a lack of operational know-how.
For tech consultants, reducing delivery risk isn’t just about protecting timelines. It’s about preventing avoidable costs from accumulating throughout the project. In this article, you’ll learn:
Let’s get started.
AI projects carry more delivery uncertainty than conventional software. Teams are often working with:
Estimates made at the start are made with the least information the project will ever have. Prototypes then add a layer of false comfort. A team that built a working demonstration in a week can start to believe production is a week away too, when the engineering behind the prototype has not yet been priced at all.
The useful correction is an equation:
Initial development is the only term most estimates cover. The other four are where AI budgets actually fail, and each of the five risks below feeds at least one of them.

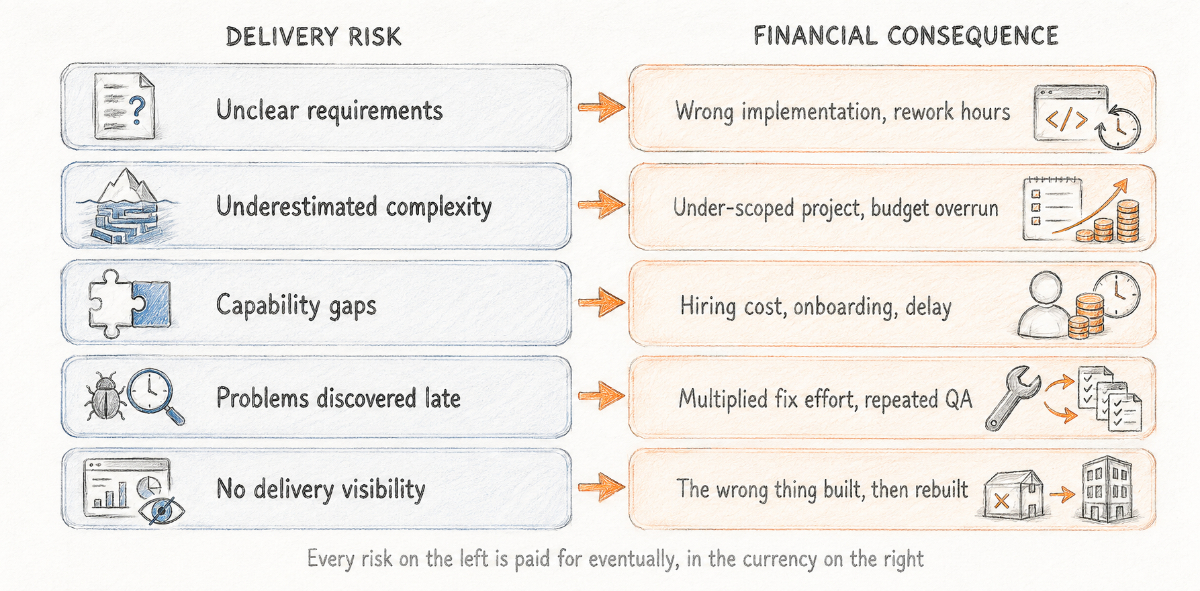

Figure 2 maps the five risks to the line items they eventually become. The sections that follow take each in turn.

A misunderstood requirement rarely announces itself. It shows up as a wrong implementation, and the chain from there is short:
Wrong implementation → rework → additional engineering hours
Consultants reduce this risk by defining, before the work is estimated:
Acceptance criteria deserve particular attention on AI projects. “The model answers questions about our documents” and “the model answers with at least this accuracy, on these document types, within this response time” are two very different builds. Only the second can be tested, estimated, and signed off.
The earlier the ambiguity is discovered, the cheaper it is to correct.
A working prototype hides most of what production requires:
When those surface after the estimate is committed, the financial consequence is predictable:
Underestimated complexity → under-scoped project → additional engineering → budget overrun
Consultants protect themselves by evaluating production requirements before committing to a delivery estimate, not after.
AI projects have a habit of suddenly requiring specialists:
The obvious response is hiring. But hiring carries its own bill:
For a consultancy the gap is paid for twice. The client-facing timeline slips, which costs trust, while the rest of the team idles or improvises around the missing skill, which costs margin.
The same defect has very different prices depending on when it is found. Caught during development, it is a small fix. Caught later, it means investigation, rework, and regression testing, because other work now stands on top of it. The cost climbs at each stage:

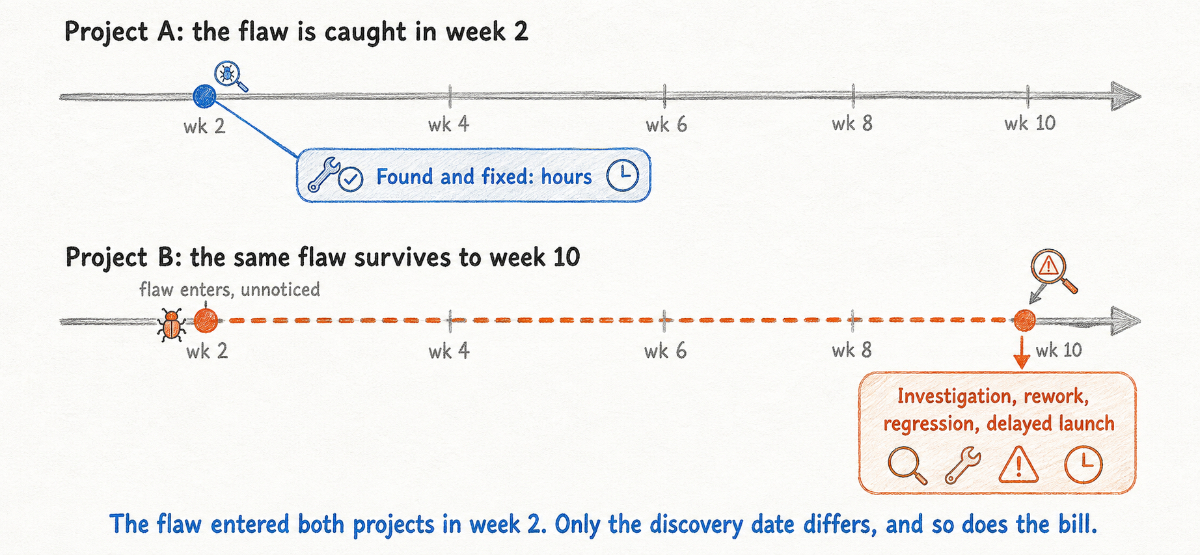

Figure 3 makes the point as two projects. The flaw entered both in week 2; only the discovery date differs, and the discovery date is what sets the cost.

This is measurable. Umaku’s July analysis, covered later in this article, estimated avoided rework purely from finding bugs and scope risks while sprints were still active. The principle for consultants to internalise:
The earlier a problem is discovered, the less expensive it is to fix.
Projects drift. Each handoff bends the meaning slightly, and nobody notices in the moment because each step looked reasonable from the step before:
Business requirement → roadmap → sprint → ticket → implementation
The discovery comes late, and it usually takes one of four forms:

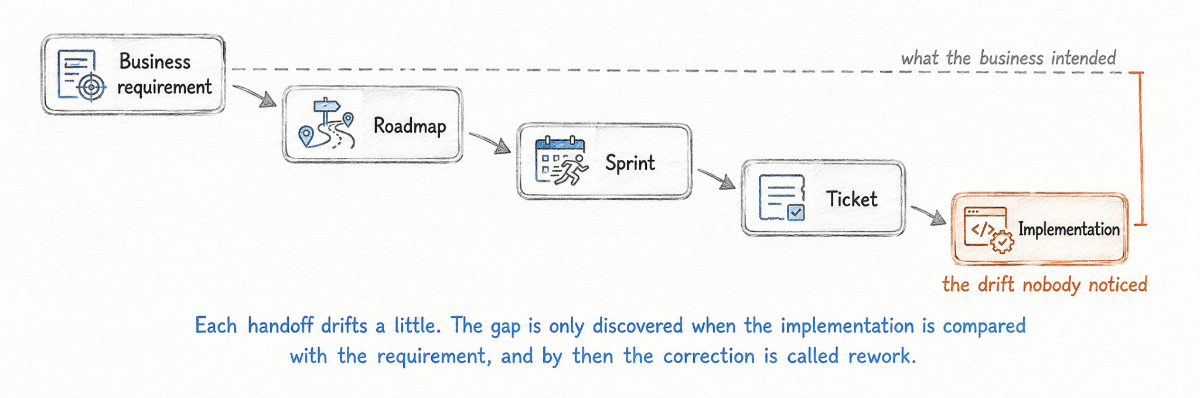

Figure 4 shows the mechanics. Whatever form the discovery takes, the invoice reads the same way: rework.

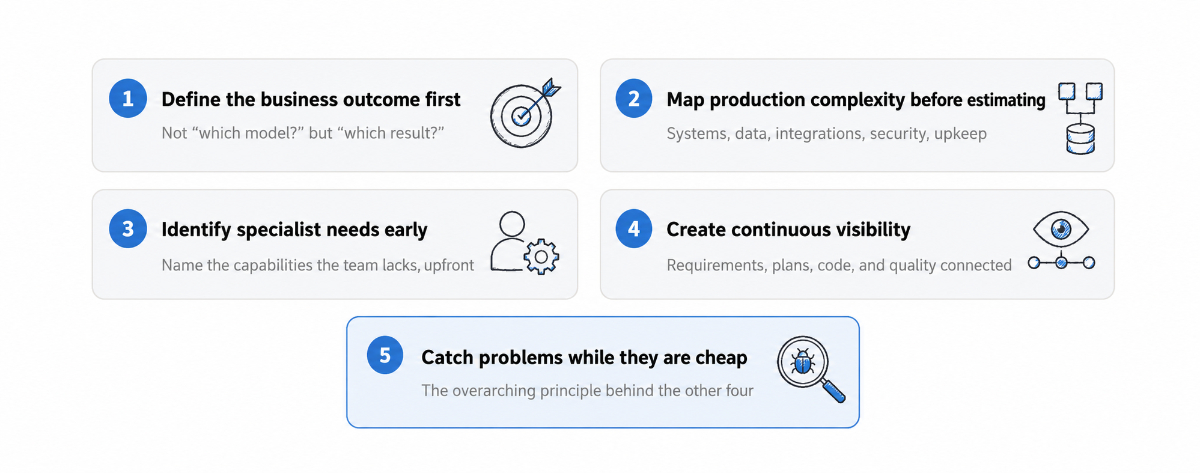

The five risks respond to five working practices, summarised in Figure 5. Together they form a practical framework for keeping AI project costs where the estimate put them.

Don’t begin with: “What AI model should we use?” Begin with: “What business outcome are we trying to achieve?”
Starting from the outcome prevents the expensive version of success: a technically impressive system that is commercially irrelevant.
Before providing a delivery estimate, map the environment the solution has to live in:
Every item left off this list at estimation time becomes unbudgeted engineering later.
Ask one question at the start of every engagement: what capabilities does this project require that the current team doesn’t have?
Naming the gap early lets the consultant close it deliberately. It is also the point at which external expertise becomes financially attractive, rather than a mid-crisis expense.
Don’t wait until the end of a sprint or project to discover: “This isn’t what we intended.”
Keep requirements, delivery plans, code, and quality signals connected throughout development, so drift is visible while it is still cheap to correct.
This is the principle behind the other four. Every practice above exists to move discovery earlier, because:
The cheapest problem is the one discovered before the team builds more work on top of it.
Practices four and five are the hardest to sustain through discipline alone. Even a highly capable team generates expensive rework if problems aren’t identified early. That is where tooling earns its place.

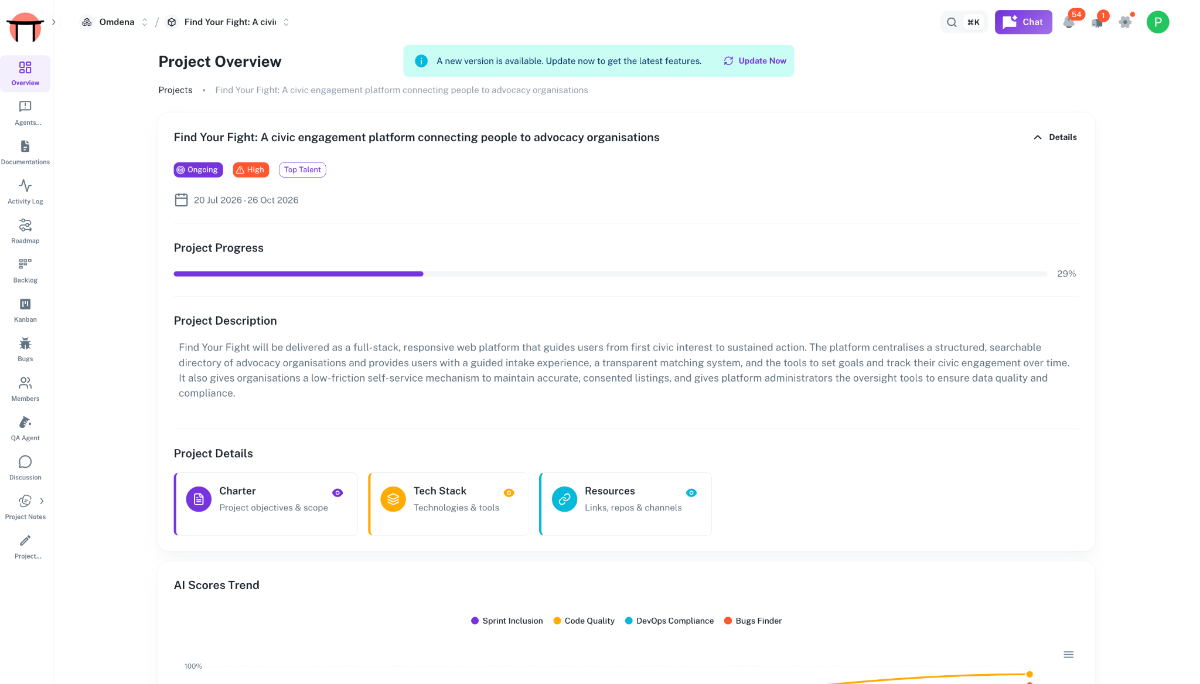

Umaku, Omdena’s delivery platform, connects the full project context:
It then runs context-aware analysis across Sprint Inclusion, Code Quality, DevOps Compliance, and Bug Finder while the sprint is still active.

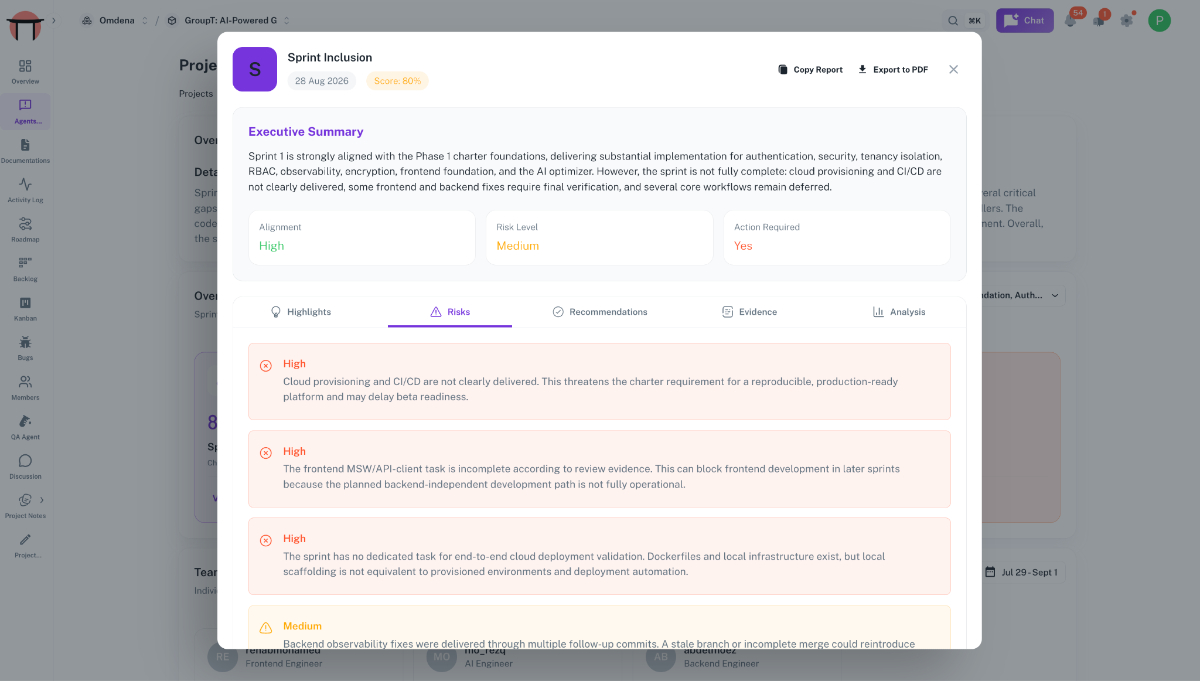

Sprint Inclusion shows whether planned work matches the agreed scope and flags requirements missing from the sprint; the technical analyses surface implementation problems before they reach a formal QA cycle.

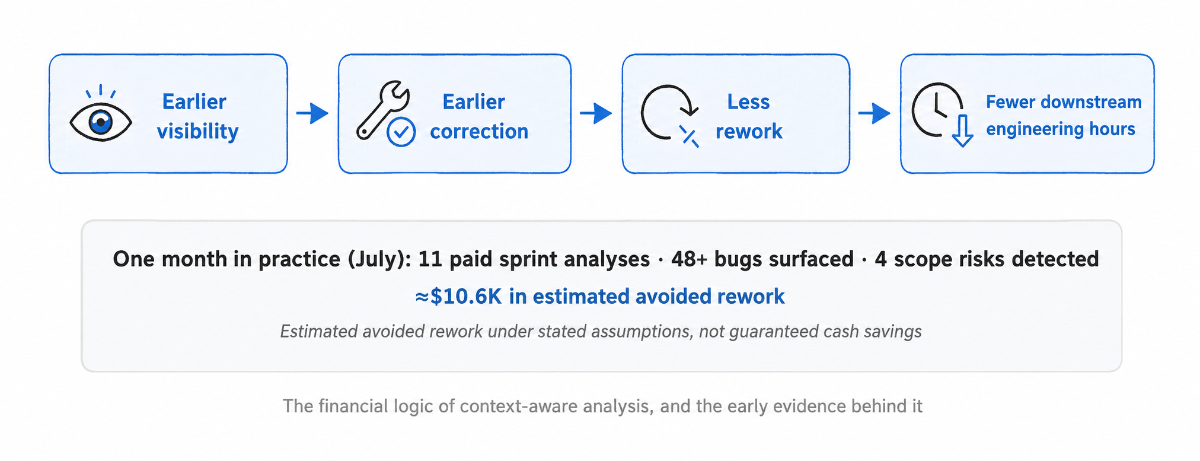

The financial connection is direct:
Earlier visibility → earlier correction → less rework → fewer downstream engineering hours
In July, across 11 paid sprint analyses, Umaku surfaced approximately 48 bugs and 4 scope risks while sprints were still active, producing a base estimate of $10.6K in avoided rework. That represents estimated avoided rework under stated assumptions, not guaranteed cash savings.

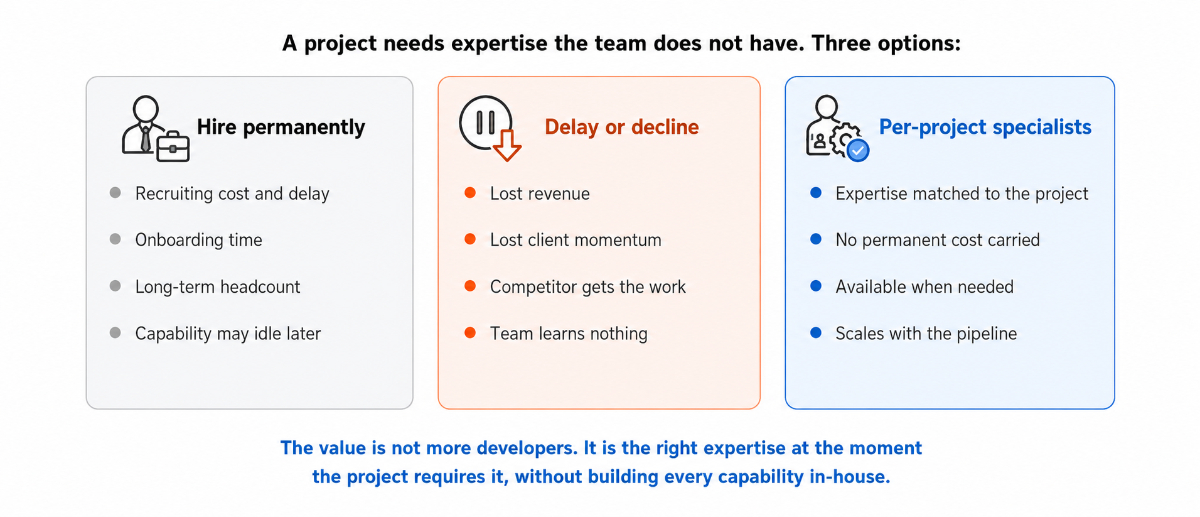

Tooling addresses visibility; it does not close a capability gap. When a consultant wins an AI project requiring expertise the team doesn’t have, there are three options:
Figure 8 compares their economics.

The third option is what Omdena’s global talent network provides. Specialists are matched to the project’s requirements rather than carried as permanent headcount, and a client-billable project doesn’t stall while a recruiter searches:
The value isn’t simply access to more developers. It’s access to specialised expertise when the project requires it, without requiring the consultant to build every capability in-house.
Handled well, the arrangement compounds. External specialists transfer knowledge as they deliver, so each engagement leaves the core team more capable than it started, at no cost beyond the work itself.

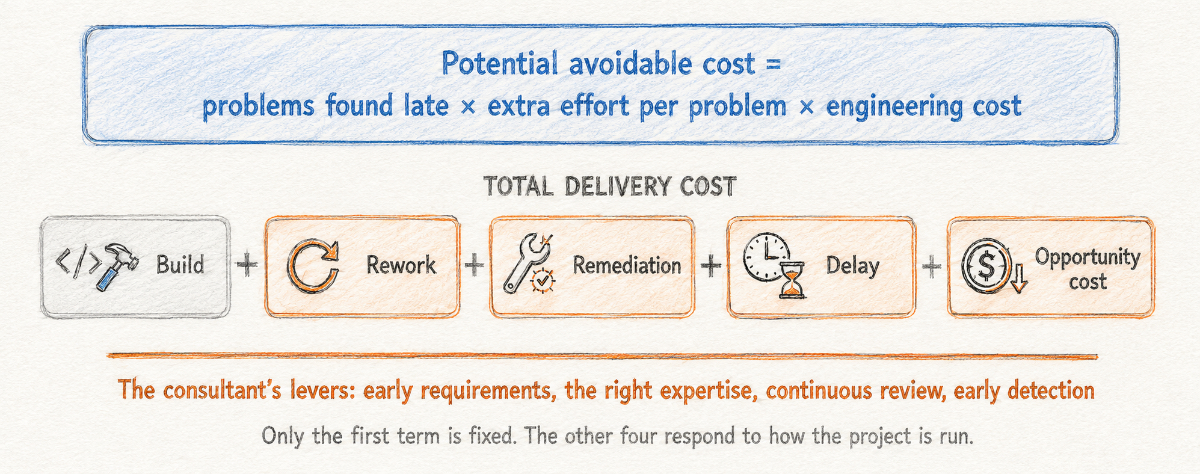

The whole argument compresses into a formula worth keeping on hand:
Potential avoidable cost = problems discovered late × additional effort required × engineering cost
Every practice in this article shrinks one of those three factors. Expand it to the full cost equation:
Total delivery cost = build + rework + downstream remediation + delay + opportunity cost
The build term is largely fixed once scope is set. The other four are the consultant’s levers, and each responds to a specific practice:
That is what makes the framework useful beyond any single tool or vendor. Figure 9 summarises it.

A consultant is not valuable for recommending AI; clients can get that recommendation anywhere. The value is turning an AI investment into a successful outcome without unnecessary waste. That means:
The consultant has to manage not only what gets built, but also how much unnecessary work gets created along the way.
The two Omdena capabilities in this article serve that role from opposite ends.
Addresses capability gaps, so projects are neither under-skilled nor stalled while a search runs.
Addresses visibility, quality, and rework, so problems surface while they are still cheap.
Together:
The right expertise + earlier visibility = fewer avoidable delivery costs.
AI projects don’t become expensive only because the technology is expensive. They become expensive when engineering time goes to problems that could have been identified earlier, and when teams lack the expertise to solve hard problems efficiently. Both drains are controllable, and both are the consultant’s job to control.
Helping clients adopt AI is the easy half of the role. Helping them avoid wasting money while doing it is where a consultant earns the relationship.
Omdena helps consultants reduce these costs through access to specialised AI and engineering talent and Umaku’s context-aware delivery platform. Either conversation can start from a single current project.
